AIP Supplement for Thailand

AIRAC AIP SUP

B 23/26

Effective from 01 OCT 2026

to 13 AUG 2027

Published on 20 AUG 2026

  CONSTRUCTION OF RUNWAY EXTENSION, RESA, NEW PARALLEL TAXIWAY,NEW TAXIWAY
AND APRON EXTENSION, OVERLAY AND REVISION OF AIRFIELD LIGHTING SYSTEMS
AT RANONG AIRPORT (VTSR)

1  INTRODUCTION

With effect from 1 October 2026 at 0100 UTC to 13 August 2027 at 1700 UTC, this AIP Supplement is to inform all concerned of construction of runway extension, RESA, new parallel taxiway, new taxiway and apron extension, overlay and revision of airfield lighting systems at Ranong Airport.

2  DETAILS

2.1 The construction works include runway extension, RESA, new parallel taxiway, new taxiway and apron extension, overlay and revision of airfield lighting systems. The details are as follows:
No.ActivitiesPeriodHours of
Operation (UTC)
CoordinatesRemarks
1Construction of new parallel taxiway1 Oct 2026
-
20 Feb 2027
0100 - 1700See the attach chart
for detail
-
2Construction of new taxiway1 Oct 2026
-
30 Oct 2027
0100 - 1700-
3Construction of new apron and
extension apron (Existing apron)
1 Oct 2026
-
30 Dec 2026
0100 - 1700-
4

Construction of runway 20

  1. extension RWY and turn pad

  2. Pre-threshold

  3. Runway strip

1 Oct 2026
-
30 Dec 2026
0100 - 1700Runway 20-
5Construction of RESA RWY 2030 Dec 2026
-
31 Mar 2027
0300 - 2200Extend from
runway threshold 02
-
6Overlay of existing apron1 Feb 2027
-
30 Apr 2027
0100 - 1700Existing ApronExisting apron are closed
7Overlay of Taxiway A and B1 Feb 2027
-
30 Apr 2027
0100 - 1700Taxiway A and BTaxiway A and B
are closed
8Revision of airfield lighting system1 Oct 2026
-
12 Aug 2027
0100 - 2200--
13 Aug 20270100 - 1700
2.2 All equipment must not be over 14 feet above ground level.
2.3 All workers and equipment must vacate runway strip within 15 minutes to accommodate flight operations (take-off and landing).
2.4 Flashing red lights (unserviceability lights) will be displayed 0.5 metres above ground level at intervals of 3 metres to mark construction site. Vehicles and machinery in the site are all marked by 90 x 90 cm orange and white checkered flags. Personnel in the site are required to wear a reflective safety vest to meet safety requirements.

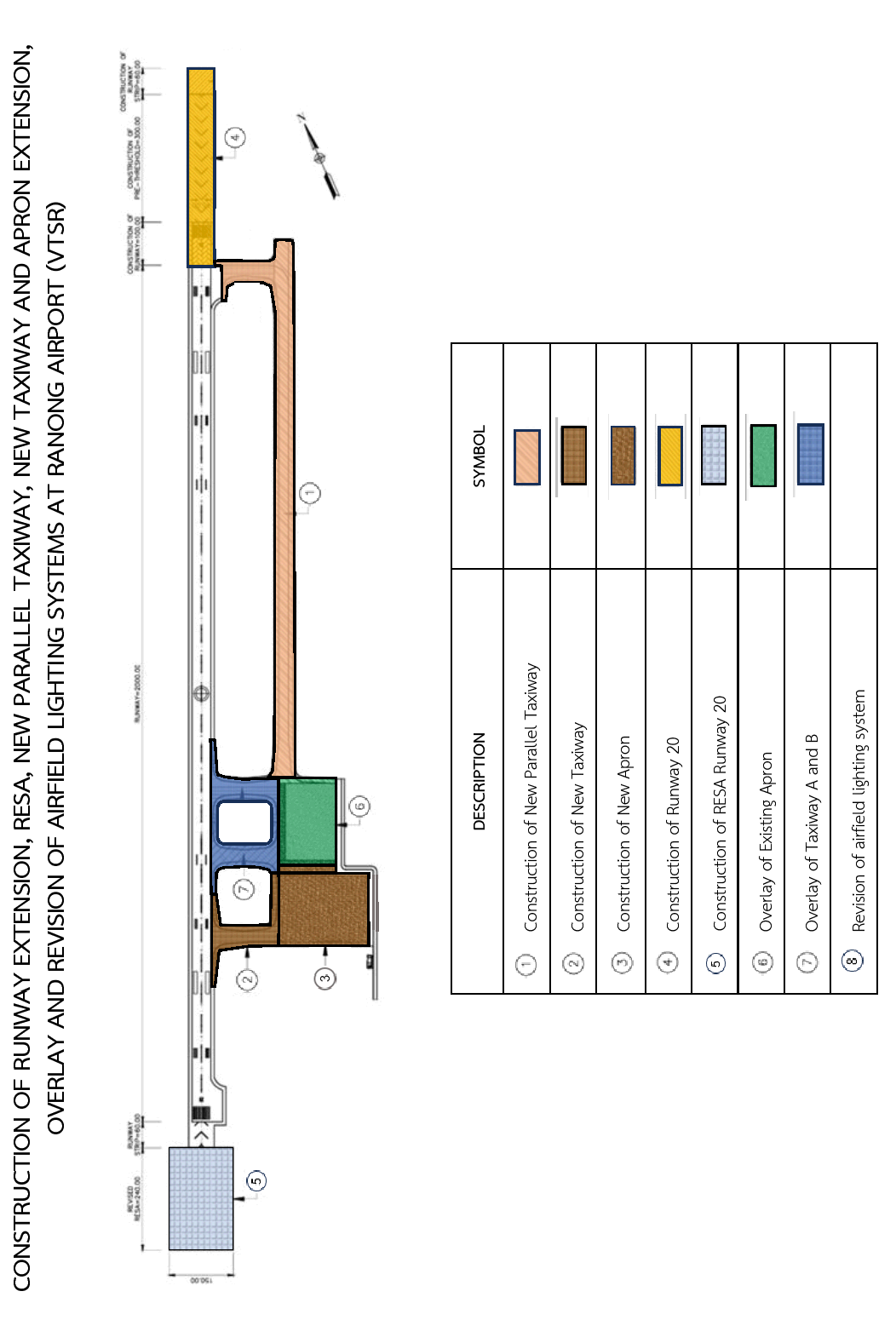

2.5 The chart related to the construction is attached herewith.

3  CONTACTS

3.1 Mr. Ruamsak Nukulroj
Tel: +668 3610 7798
E-mail: [email protected]
3.2 Mr. Suppachai Aumnioysombat
Tel: +668 1159 4750
E-mail: [email protected]

4  VALIDITY

This AIRAC AIP Supplement will remain current until 13 August 2027 at 1700 UTC. Any changes to this AIRAC AIP Supplement will be notified through NOTAM.
